Case study · Construction

4D Construction Progress Monitoring Against BIM

Progress is now recorded element by element, floor by floor, as proof both sides of a contract can open.

P1 · Site

The system tracks concurrent tower builds like this one from a single operator’s walkthroughs.

A construction group with multiple live sites tracked progress through walkthroughs and spreadsheets. Brainy Neurals built a 4D monitoring system that rebuilds sites in 3D and checks every element against the BIM model. The group reports 40 to 60 percent less supervision effort, with deviations flagged weeks earlier.

Supervision effort

40–60% lower

Deviation flags

Weeks earlier

Progress record

Every element

02 / Glance

The engagement at a glance

Q1

What problem did this solve?

A construction group running multiple concurrent sites tracked progress through manual walkthroughs and spreadsheets. Schedule deviations stayed invisible until billing, when rework was already expensive.

Q2

What did Brainy Neurals build?

Brainy Neurals built a 4D progress monitoring system that reconstructs each site in 3D from 360-degree video. Every detected element then matches to its exact BIM object.

Q3

What changed after it went live?

The construction group reports 40 to 60 percent less manual supervision effort and deviations flagged weeks earlier. Progress is now recorded element by element as digital proof.

Q4

Who else could use this?

Any operator building large physical assets against a design model can use this pattern. Rail, industrial plants, shipbuilding, data center fit-outs and heavy civil infrastructure all qualify.

Industry

Construction

Sub-vertical

Commercial building projects

Client

Multi-site construction group

Engagement

Full system build

Timeline

Months to first deployment

Capabilities

Computer vision, 3D, BIM

Delivery model

Standardized multi-site rollout


03 / Problem

Why manual progress tracking kept failing

Progress on the group’s sites was tracked on foot, one walkthrough at a time. Engineers walked each floor, judged completion by eye, and typed percentages into a spreadsheet. Nothing tied what stood on the slab to the building information model, the BIM, the project was contracted against.

Brainy Neurals was brought in to close that gap with computer vision built for live construction sites.

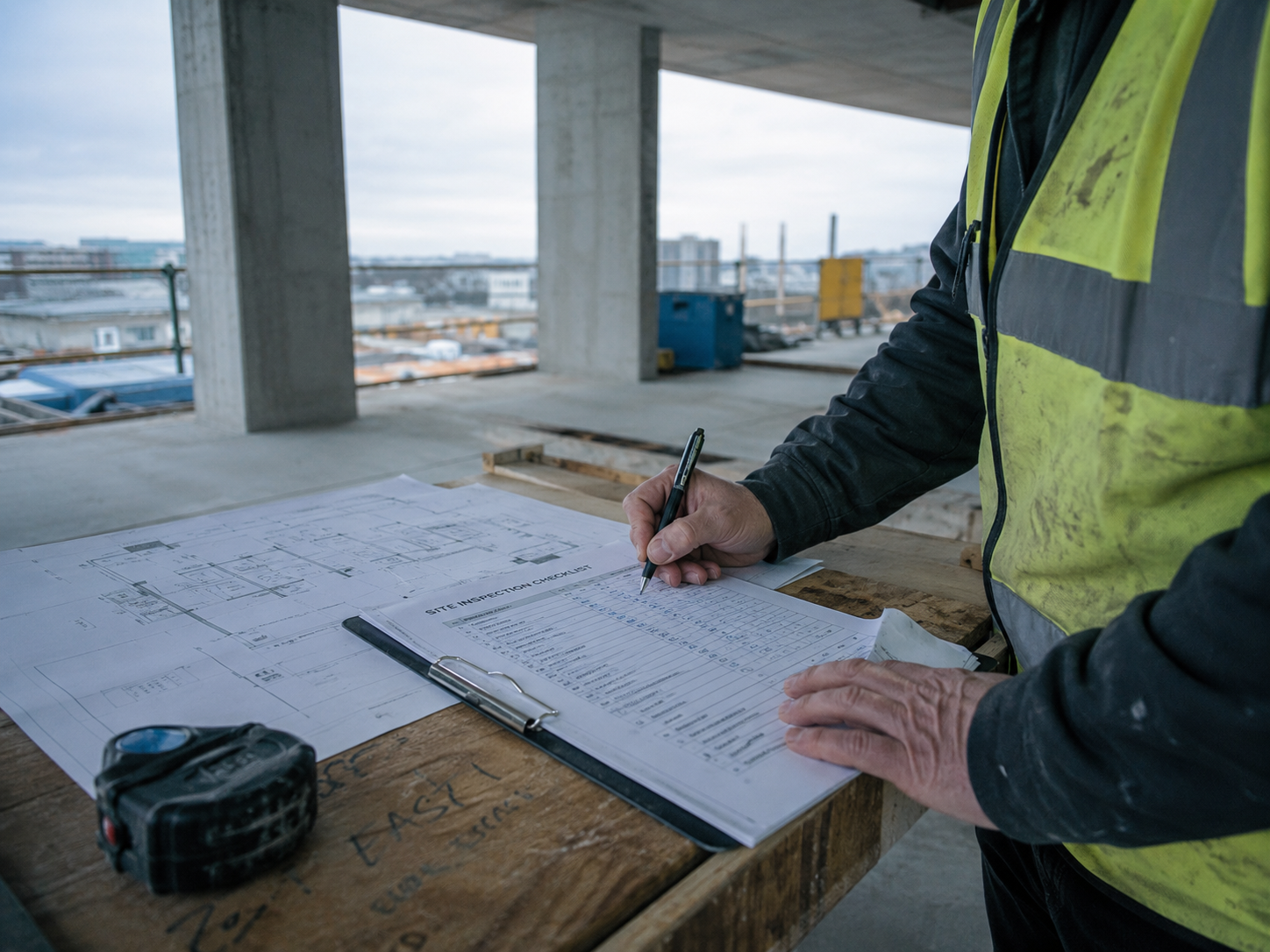

Site engineer marking a paper progress checklist by hand before automated progress tracking
P2 · Before

Completion was judged by eye, floor by floor, and typed into a spreadsheet afterwards.

Four ways it broke

  1. 01The weekly report and the floor disagreed, and both numbers were honest opinions.
  2. 02The deviation surfaced at billing, when the claim and the site disagreed.
  3. 03The stakeholder update was one engineer’s judgment, retyped weekly, with nothing behind the percentage.
  4. 04The rework bill grew quietly, because a deviation found at billing is months old by then.

Rework is not a rounding error. One study of 359 projects put direct rework costs near 5 percent of total construction cost (DOI: 10.1061/(ASCE)0733-9364(2009)135:3(187)).

The breaking moment was always the same: a billing meeting, two truths, and no record to settle it.

04 / Options

Why do progress photo tools fall short?

Most builders try something cheaper first, and each approach works up to a point.

Five approaches to measuring what is built
ApproachWhat it gets rightWhere it stopsWho it still suits
More site walksCheap and familiarSubjective, and photos never tie to model elementsOne small project
Fixed timelapse camerasA continuous recordSees facades, not interiors, nothing per elementExterior milestones
Laser scanning surveysSurvey-grade geometryNeeds a crew and a booking, so cadence stays lowFinal as-built handover
Drone photogrammetryFast exterior coverageCannot fly interiors routinelyEarthworks and shell
360-degree video matched to BIMInteriors, one operator, element statusNeeds a design model to compare againstMulti-site builders working to BIM

Academic researchers matched site images to individual 4D BIM elements as early as 2015 (DOI: 10.1016/j.autcon.2015.02.007). But most photo tools skip that element link, which keeps them documentation rather than measurement.

Tried this and hit the same wall? Tell us where it stopped.

Tell us where it stopped

05 / Design

How we designed the monitoring system

Brainy Neurals built the 4D construction progress monitoring system for a construction group running multiple concurrent commercial sites.

One person walks each floor with a consumer 360-degree camera on a pole. Software rebuilds that walk in 3D, registers it to the BIM coordinate frame, and works out which designed elements exist. Each finished capture becomes a timestamped as-built snapshot of that floor.

The sequence of snapshots is the fourth dimension: the building against its plan, over time.

The camera moves through the building but the model never moves, and that fixed frame is what makes progress measurable.

05 · Design principle

Under the hood this is video analytics at full building scale: hours of footage in, element statuses out.

D1 · System and its boundaries

Supporting

On siteProcessingStakeholders Inputs 01360 capture 02Upload 033Drebuild 04BIMregistration 05Elementdetection 06Identitymatch 08BIM model 09Schedule 10Dashboards 11PDF reports 12Deviation flags 07Progressengine
D1 · System

Capture happens on site, reconstruction and matching happen in the processing pipeline, and reports reach every stakeholder.

Decision 01

Match by identity, not geometry alone

Every BIM object carries a stable identifier, so the system reports status per element rather than per photo.

We rejected geometry-only comparison, because it proves something exists without saying which contracted item it is.

Decision 02

Consumer capture over survey-grade scanning

Routine laser scanning needs a crew and a booking, so we ruled it out.

A measurement nobody repeats is not monitoring.

06 / Stack

The technology stack we used

Every layer had one test: could a site team run it without us standing next to them?

The stack below is the version that survived that test on every site. It favors capture anyone can operate, reconstruction that tolerates live sites, and outputs that read like engineering documents. The wider toolbox is mapped across Brainy Neurals’ AI development services.

#LayerWhat we usedWhyWhat we ruled out
01CaptureA consumer 360-degree camera on a poleOne operator, a floor in one passSurvey-grade laser scanners
02ReconstructionProprietary 3D AI engine combining spatial mapping and vision pipelinesSolid geometry from ordinary walking videoStill-photo photogrammetry runs
03RegistrationAutomated alignment to the BIM coordinate frameEvery capture lands on one fixed frameManual alignment per visit
04Model layerA BIM parsing engine reading the element treeStable identifiers, in the open IFC standardFlat geometry exports
05DetectionVision models tuned to structural classesWalls, beams, columns and slabs in the rebuildGeneric scene segmentation
06Progress engineElement status and deviation logic against scheduleBuilt, partial or not started, datedPercent-complete guesswork
07DeliveryFloor-wise dashboards and PDF engineering reportsRolls element to floor to building to siteRaw 3D viewers

07 / Sequence

How does 4D progress monitoring work?

Follow one Tuesday-morning capture all the way from the slab to the finished report.

D2 · One capture end to end

Primary

Animated six-step flow from 360-degree floor capture to BIM-matched element status and deviation-flagged reports ELEMENTFLOORBUILDINGSITE SCHEDULE PLANNED BY DEVIATION FLAGGED SCHEDULE CAPTURE 01 CAPTURE 02 CAPTURE 03 THE BUILDING AGAINST ITS PLAN, OVER TIME TUESDAY MORNING AI ENGINE BIM MODELINPUTANCHORSMODEL FIXED WALLSBEAMSCOLUMNSSLABS BUILTPARTIALNOT STARTED REPEAT CAPTURE AGREES

Coda · The fourth dimension

D2 · Sequence

One walkthrough becomes element-level status in six steps, with deviations flagged against the schedule.

Any engineer can narrate this back to their own team, and that is deliberate.

Want this walked through for your setup? Book 30 minutes with Mitesh Patel.

No pitch. If it is not a fit, you will know in five minutes.

Book 30 minutes

08 / Hard parts

Three problems that nearly stopped us

Three problems ate most of the engineering time, and none of them shows up in a demo.

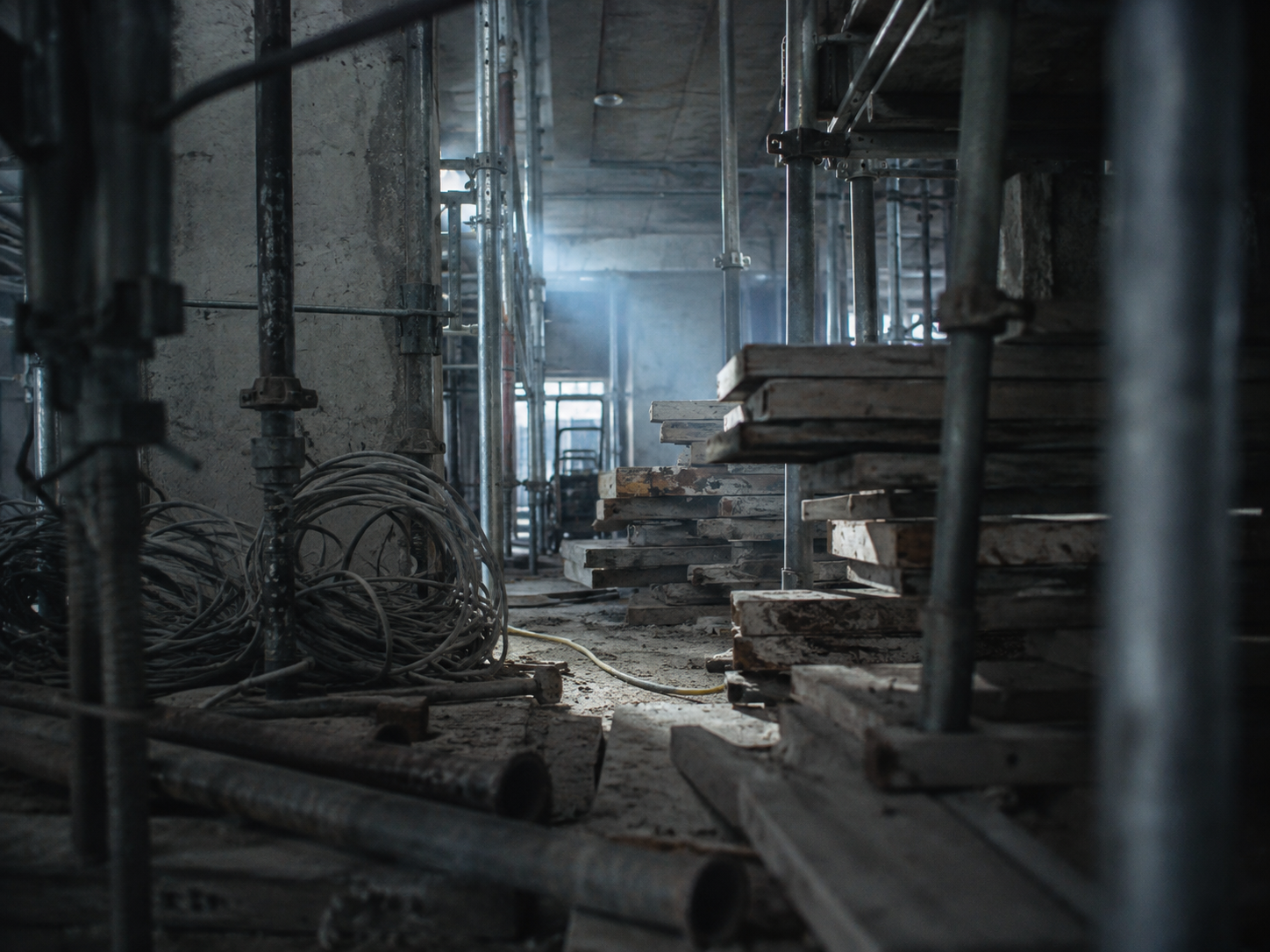

Cluttered concrete interior with scaffolding, the occlusion problem in construction progress tracking
P3 · Environment

Temporary works hide finished elements, and a hidden wall reads as an unbuilt wall.

Drift.

Long interior walks accumulate small reconstruction errors, corridor by corridor, until the rebuild refuses to sit on the model.

Twin floors.

Concrete towers repeat, so floor eleven looks exactly like floor twelve, and progress gets filed against the wrong level.

Occlusion.

Scaffolding, stacked boards and parked lifts hid finished work, and a hidden wall reads as an unbuilt wall.

Reviews of sensing-based progress monitoring name the scanning environment itself as a deciding factor in data quality (DOI: 10.3390/s22093497).

Concrete dust got into everything too. Lens housings, laptop fans, coffee.

Problems in this class are why builders extend the bench with specialist engineers instead of starting from zero.

09 / Fixes

How we solved each one

Each fix below pairs to its problem, and none of them is exotic engineering.

Problem 01

Drift

Drift got anchored registration.

The rebuild snaps to fixed reference geometry first, coarse then fine, so error resets before it compounds. Long walks now land on the model instead of near it.

Problem 02

Twin floors

Twin floors got model-aware matching.

The BIM already knows which elements can exist on which level, so the design itself disambiguates lookalike floors. The model became the map.

Problem 03

Occlusion

Occlusion got evidence thresholds.

An element changes status only when repeated captures agree, so a parked pallet cannot un-build a wall. Statuses move slower and get argued with less.

L2 · The shape of the fix

Ambient

Drift Anchor Corrected path
L2 · Registration

Fixed anchors reset reconstruction drift before it can compound across a floor.

We shipped it in staged releases against live sites, the pattern our engagement models describe. All three fixes are the difference between a demo and a system a contractor bills against.

10 / Result

What changed after go-live?

Manual supervision effort

4060% lower

One number carries this block. The construction group reports manual supervision effort down 40 to 60 percent across the sites where the system runs. The figure is the client’s own measurement, and we print it exactly as reported.

OutcomeDetail
Where the hours went

The recovered supervision hours went back into coordination and quality, not into more walking.

Timing moved further than hours

Deviation timing moved further than any recovered hour count. Slippage that surfaced at billing now flags weeks earlier, while it’s still a schedule conversation. Not yet a claims fight.

Disputes changed shape

And disputes changed shape. A progress claim now arrives with an element-level record attached, so both sides argue against the same evidence.

What we have not measured

We have not published a rework figure, though the client reports the direction is down. A number we have not measured is a number we will not print.

D3 · The change, quantified

Primary

BeforeAfter rolloutAfter Manual walksSpreadsheet entryBilling surprises One-operator captureElement statusWeeks-early flags Supervision effort · baseline 40–60% lower
D3 · Change

The client reports supervision effort down 40 to 60 percent since rollout.

Conversion · the ask

Tell us what you track by hand

Progress, safety, plan compliance, handover. If a person walks it and types it, describe it in one line and we will tell you whether it is measurable.

Reply comes from the person who would architect it







    11 / Today

    What is running today

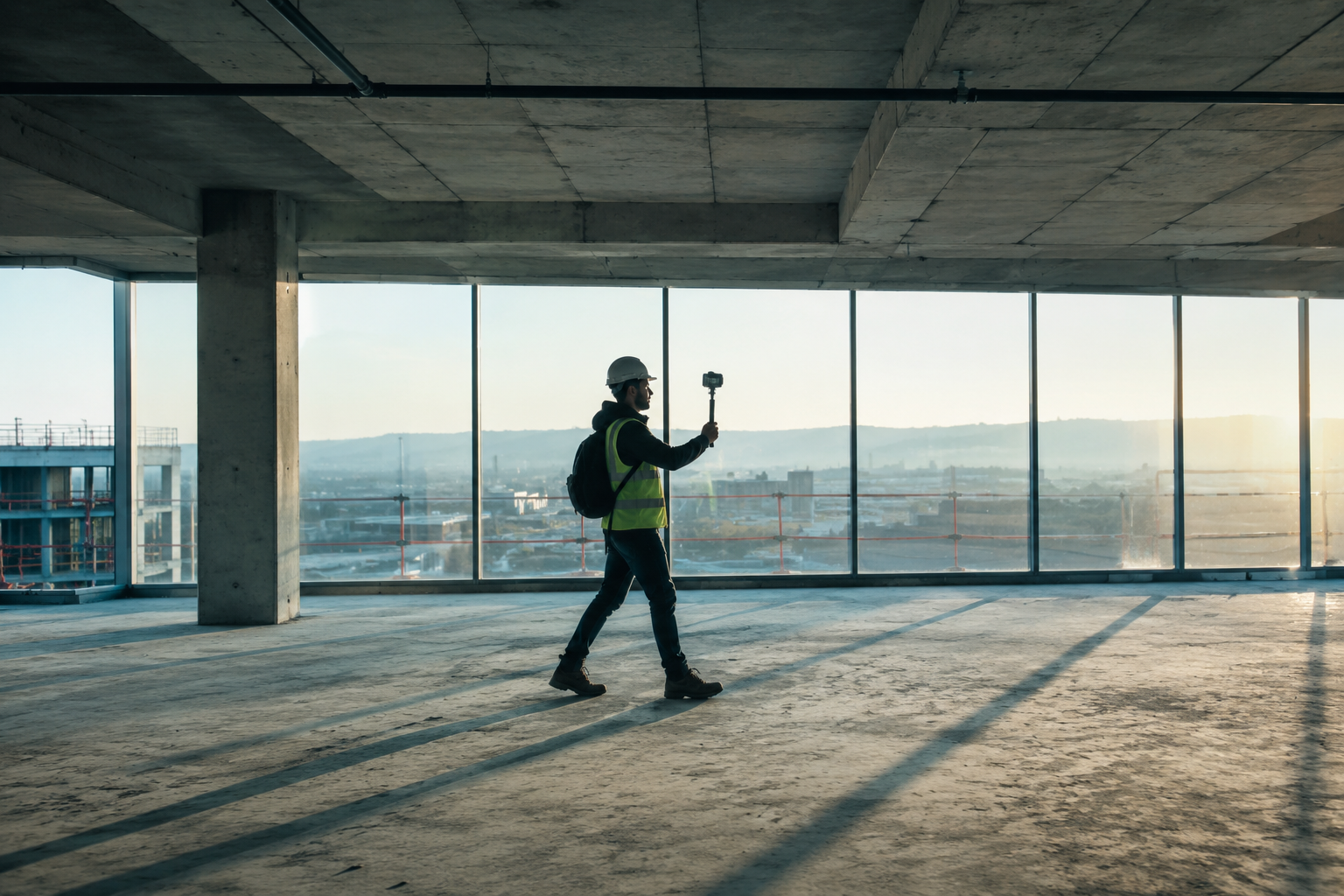

    Engineer walking a floor with a 360-degree camera for as-built capture
    P4 · Routine

    One engineer, one camera on a pole, one floor per pass, inside the normal routine.

    The system runs in production across multiple concurrent sites, on a standardized rollout the group repeats for each new tower.

    A site engineer walks each floor with the camera as part of the normal routine. Reconstructions land in the pipeline, dashboards update floor by floor, and the PDF reports go straight into progress meetings.

    Coverage has grown since handover without Brainy Neurals engineers on site, which is the point. And it is most of what construction teams now ask us about.

    12 / Lessons

    What we would do differently

    Four lessons survived contact with the site, and one of them still stings.

    Lesson 01

    Write the walk protocol first

    We under-scoped the protocol, and early captures varied noticeably from engineer to engineer. The geometry was fine, but consistency wasn’t, and one written page fixed more than any model change.

    Lesson 02

    Bind to element identity early

    Matching stable BIM identifiers from day one made every later feature cheap, dashboards and dispute records included.

    Lesson 03

    Report the way sites argue

    Floor-wise PDF reports got adopted because they match how billing meetings actually run.

    Lesson 04

    Show the evidence next to the status

    So every published status links back to the capture that produced it.

    A progress number nobody can check is a progress number nobody will trust.

    12 · Lesson four

    13 / Portability

    Where else does this pattern fit?

    As-built verification checks the physical state of an asset against its design model, using 3D reconstruction from ordinary video.

    The pattern fits wherever work is contracted against a model and billed against progress.

    L1 · The pattern on another asset

    Supporting

    Plant asset Design model Capture path
    L1 · Portability

    The same capture-and-compare pattern applies to plant construction against a dense design model.

    Six asset classes with the same shape of problem
    IndustryThe same problemWhat changes in the build
    Rail and metroStations and viaducts built over years against one designLinear referencing along the alignment
    Industrial plantsPipe racks and steelwork installed against a dense modelSmaller elements, denser detection classes
    Data center fit-outsRepetitive halls built fast on tight schedulesA services-heavy element vocabulary
    ShipbuildingHull blocks assembled to CAD in covered yardsSteel sections, no daylight assumptions
    Heavy civilBridgeworks progress claimed monthly against drawingsVolumes and chainage over elements
    Facility handoverAs-built condition proven at practical completionSnag lists tied to elements

    The nearest neighbors are plant construction in manufacturing and station work in rail, and both keep asking. Porting takes a new element vocabulary and a fresh registration target, but the pipeline itself does not change.

    14 / Questions

    Questions buyers usually ask us

    Q1Do we need a complete BIM model to start?

    No. The system needs the structural model only for the elements it will track. A partial model limits coverage, not feasibility, and coverage grows as the model does.

    Q2How often does someone have to walk the site?

    Cadence is the client’s call, and the system was built so one person handles it inside a normal routine. Vendors across this market typically report weekly or biweekly walks as the working rhythm. The tighter the walk cadence, the earlier schedule deviations flag.

    Q3How long does it take to deploy something like this?

    Expect months, not weeks, for a first production deployment, because registration, detection and reporting must all survive a live site. Repeat rollouts run much faster, and this build now extends to new sites on a standardized checklist.

    Q4What does a build like this cost?

    Scope drives it: site count, element classes tracked, and how deep the schedule integration goes. Brainy Neurals prices it as a fixed build with a pilot floor first, so the spend has an exit ramp. The honest first step is an AI readiness assessment of your model and capture maturity.

    Q5Can the output hold up in a billing dispute?

    A billing dispute is where the system earns its keep. Every element status links to the timestamped capture that produced it, so a claim arrives with evidence attached. Teams across this market use the same capture records to validate monthly payment applications.

    Q6What happens when elements are hidden behind scaffolding or materials?

    The system waits. An element changes status only when repeated captures agree, so temporary blockage reads as no change, not regression. Persistent occlusions get flagged for a human review pass instead of a silent guess.

    Ready when the spreadsheet is not. Tell us about your project.

    Cite this case study

    Patel, Ronak, and Prasiddh Mori. “4D Construction Progress Monitoring Against BIM.” Brainy Neurals, August 2026. https://brainyneurals.com/case-studies/construction-progress-monitoring/

    External sources

    • 03Direct rework costs near 5 percent of total construction cost, from a 359-project dataset. DOI: 10.1061/(ASCE)0733-9364(2009)135:3(187)
    • 04Site images matched to individual 4D BIM elements for progress tracking, published 2015. DOI: 10.1016/j.autcon.2015.02.007
    • 08The scanning environment named as a deciding factor in sensing-based progress-monitoring data quality. DOI: 10.3390/s22093497
